You're the one paying the bills, make sure you know where the costs are and how the project is progressing.
Insist on receiving these 3 reports in every Sprint Review meeting:
Let's look at those 3 reports:
This allows you to see the actual costs of the project on a weekly basis.

Figure: Project Progress – There is $30k spent and $8K outstanding

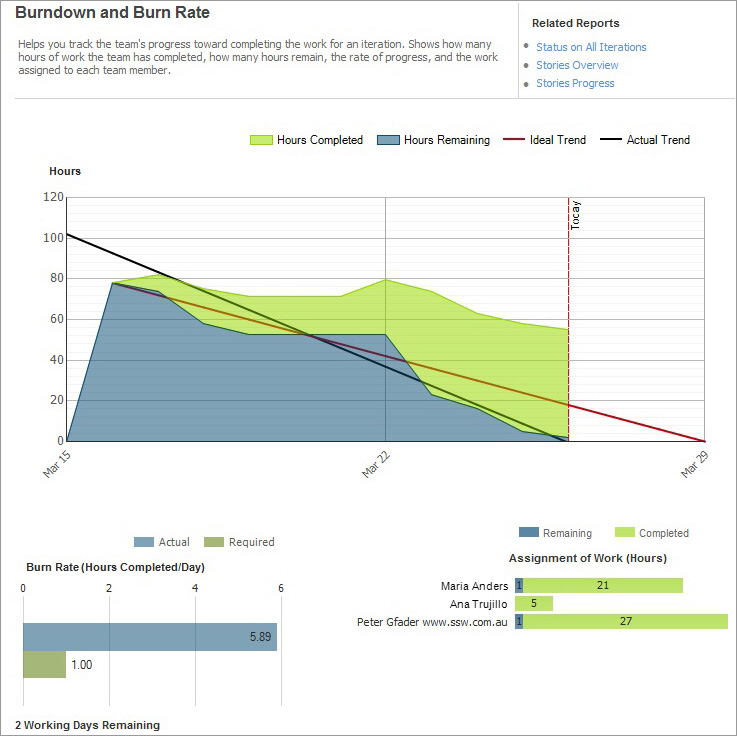

Figure: Burndown report - Shows the progress of the team in the current Sprint – ETA is March 29 and Ana has no work to do
Questions that the Burndown and Burn Rate report help answer:
See how to use the Burndown and Burn Rate Report.

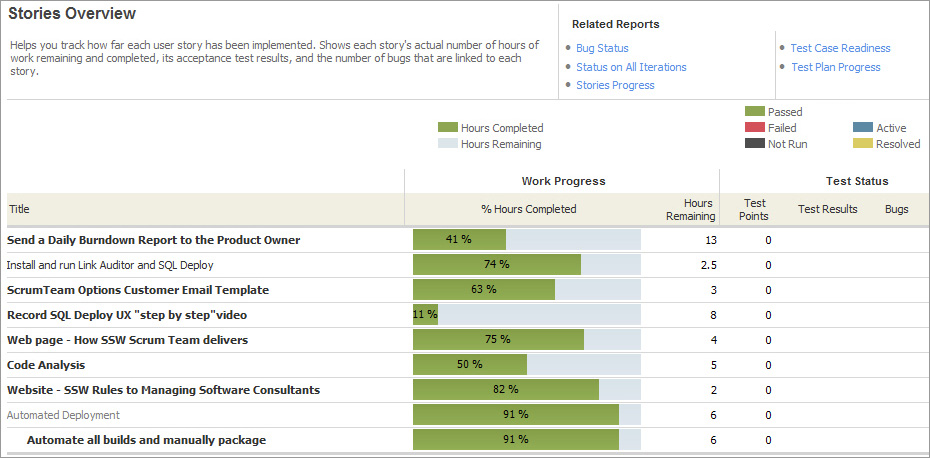

Figure: Stories Overview report - Shows the progress of the User Stories in the current Sprint and nothing has been tested and no active bugs
Questions that the Stories Overview report help answer:
See how to use the Stories Overview Report.
