As long as you have work items created and your developers keep them up to date, you can use MS Project to calculate project budget usage in real-time; this helps the project manager to determine the progress in term of $ which is what client really care about. Note: To have this working properly, you need VSTS 2010 because it has better MS Project integration.
Follow the steps below to save a baseline and track your project budget usage:

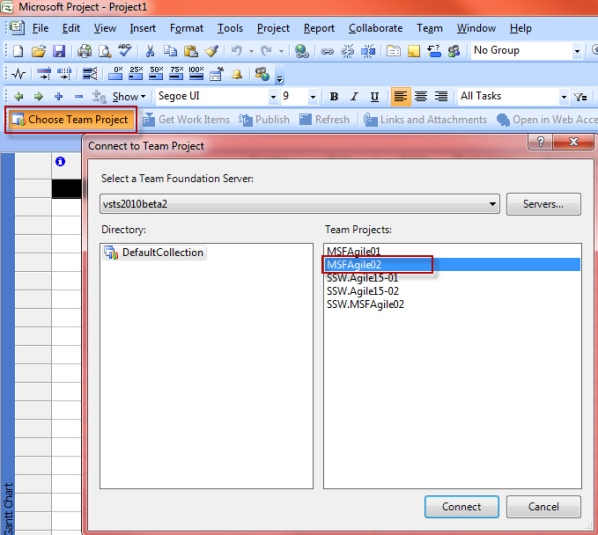

Figure: Click “Choose Team Project” and choose the project you want to track

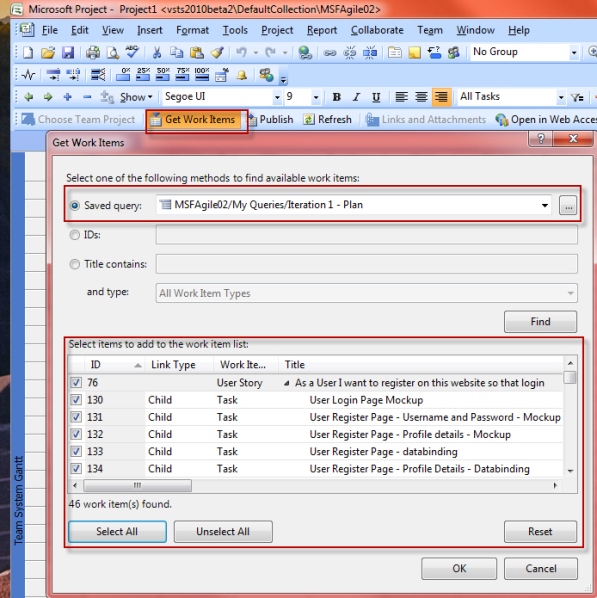

Figure: To select the work items that you want to use you should click on “Get Work Items” and choose a query

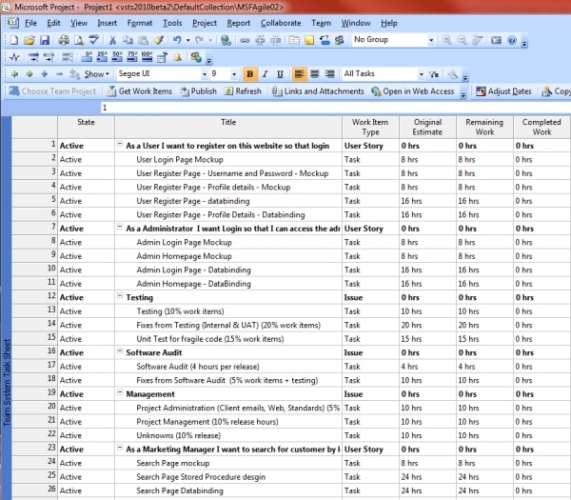

Figure: Arrange your work items so we can easily track their progress

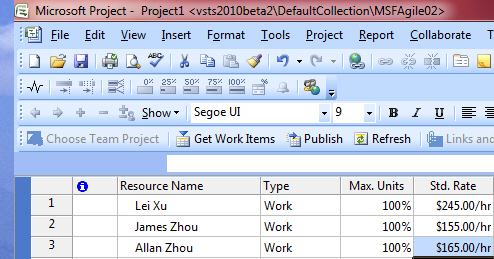

Figure: Assign resource rates
You will notice the “Remaining Cost” column has been calculated based on the “Remaining Work” column and the Rate we entered for each task.

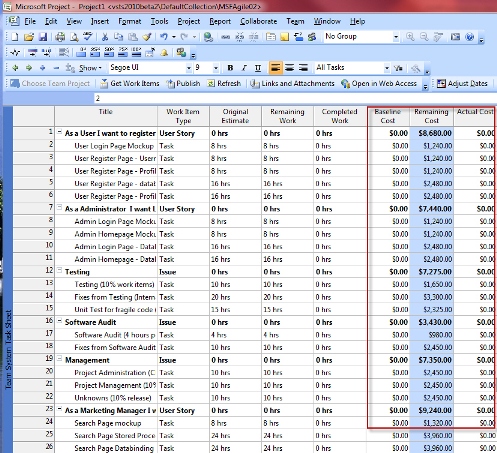

Figure: Showing the cost columns
Figure: Create a summary task at the top
Name the task as per your release name so you know what this plan is for; also you don’t want this task to be created in your TFS as a work item because it’s just a summary, set “Publish and Refresh” as “No”.

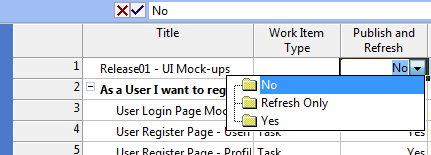

Figure: Don’t publish and refresh this summary task
In order to make this a summary item you need to select all the other tasks and indent them. To achieve this click the little red forward arrow in the toolbar.

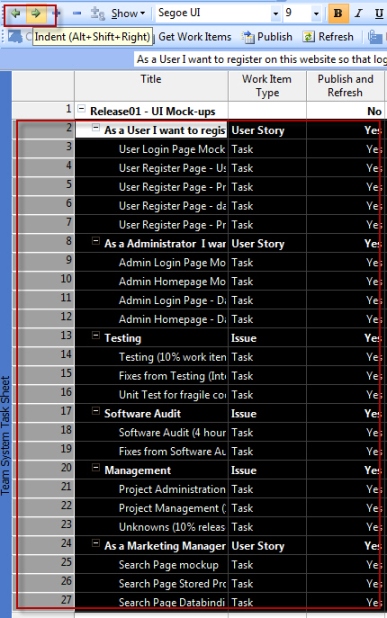

Figure: Indent tasks
Now, your summary task is ready and it’s showing the total cost for your current release:

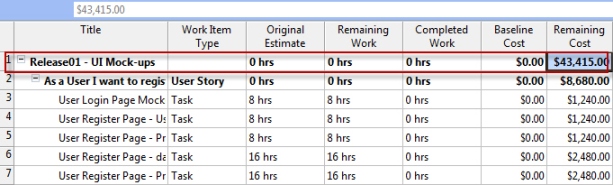

Figure: Total cost is calculated
Baseline management is very important for every project manager as it helps you to determine the budget usage; once the client approves your initial estimate for the project it will become your baseline. So before you set a baseline in your MS Project, make sure the client approves it.
To set a baseline, choose “Tools, Tracking, Set Baseline” from the menu:

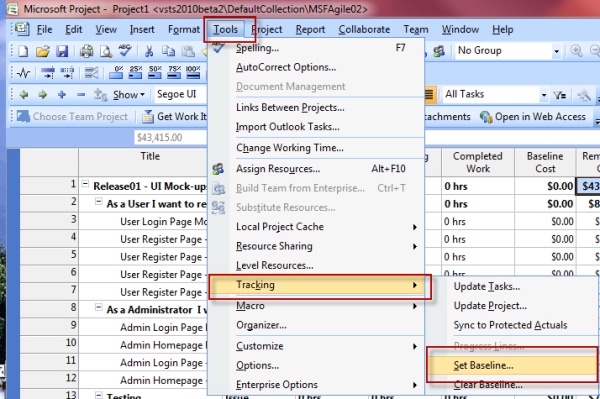

Figure: Set Baseline...

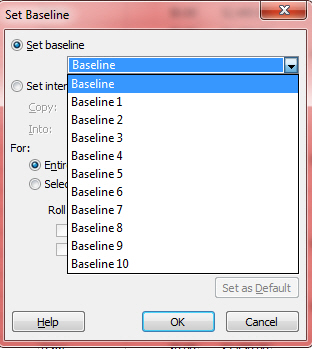

Figure: Choose “Baseline” and click ok
A handy feature of MS Project is its ability to handle multiple baselines. Use a new baseline to seek approval from clients when they alter the project scope.
Once your baseline is set, you will be able to see the “Baseline Cost” column is showing $

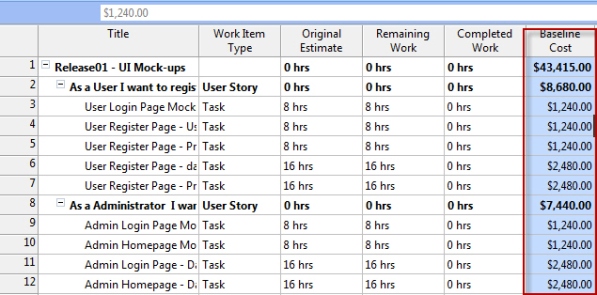

Figure: Baseline Cost is showing $
When your project is running, your developers will update the “Remaining Work” and “Completed Work” columns from TFS, they may not use MS Project so you will need to refresh your MS Project file to get these changes, and the $ will be calculated on the fly to give you up-to-date status.
To refresh your project file, simply click on the “Refresh” button in the toolbar.

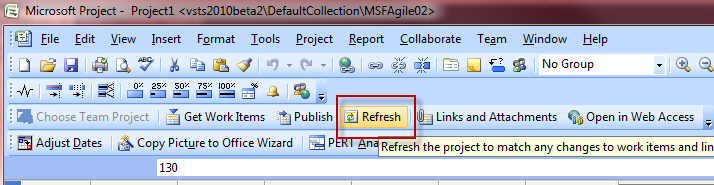

Figure: Click the “Refresh” button to update your project file

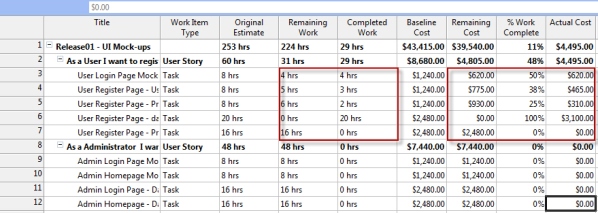

Figure: Budget usage is calculated

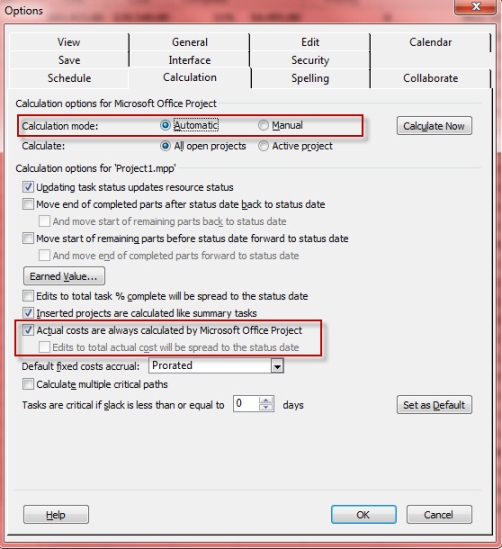

Note: If you find that the values are not calculating properly, it may be that the calculation mode is set incorrectly. If pressing F9 updates the values you should change the setting “Tools | Options | Calculation” from “Manual” to “Automatic”.
Figure: set the calculation mode to “Automatic”
Also make sure “Actual costs are always calculated by Microsoft Office Project” is enabled.
